Capital works speed up as council manages budget timing
Members of Neath Port Talbot Council were given an end-of-year update showing the authority’s 2025-26 Capital Programme largely progressing ahead of schedule, with a number of high-profile projects delivered sooner than anticipated. The report, presented at a July 2026 cabinet meeting, set out how timing changes have affected the council’s outturn position.
The capital programme for the year was described as worth more than £88 million, but earlier-than-forecast progress on several schemes meant the council’s actual capital spend for 2025-26 rose to £91.9 million. Councillors were told that, in many cases, expenditure has simply shifted between financial years rather than representing additional cost.
Which projects moved faster and what that means locally

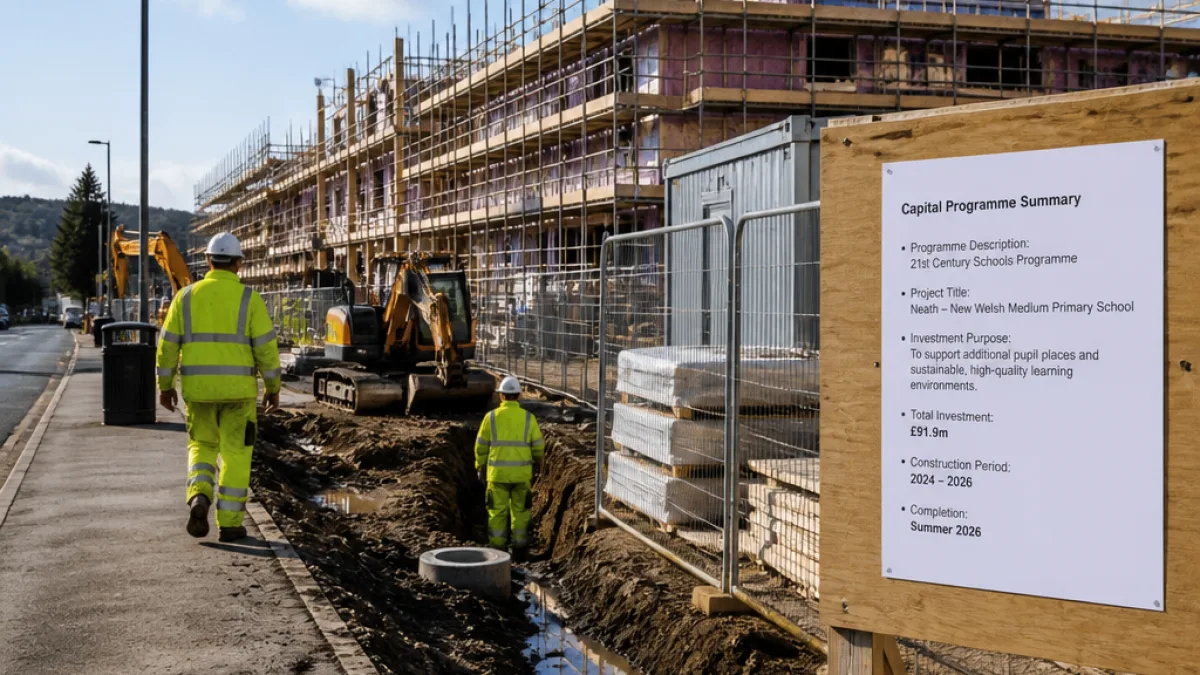

Among the schemes cited in the report were the replacement of Ysgol Gynradd Gymraeg Rhosafan, where construction works were advancing at a quicker rate than planned. As a consequence, funding originally profiled for 2026-27 has already been utilised.
Similarly, drainage improvements on the A483 Fabian Way were delivered ahead of schedule. The report also confirms that £1.954 million of Tata Transition Fund grants earmarked for 2026-27 have already been awarded and paid, again bringing forward expenditure into the 2025-26 accounts.
- Ysgol Gynradd Gymraeg Rhosafan: replacement school progressing faster than scheduled
- A483 Fabian Way: drainage improvements delivered ahead of time
- Gnoll Country Park: completion of a multi-million-pound makeover, new visitor centre and renovated Pond Cottage
- Waterfall Country, Pontneddfechan: progression of tourism infrastructure project
- Princess Royal Theatre, Port Talbot: continued renovation
The report also highlighted recently completed and ongoing regeneration work that is of local significance, including the multi-million-pound makeover at Gnoll Country Park, featuring a new visitor centre and a renovated Pond Cottage, projects to develop tourism infrastructure at Waterfall Country in Pontneddfechan, and the continued refurbishment of Port Talbot’s Princess Royal Theatre.
"It was really pleasing to see the projects progressing ahead of schedule," the council leader said, adding that the funding was interchangeable between the two years.
Financial position: modest revenue underspend, reserves drawn
Alongside the capital update, councillors received a report on the authority’s annual revenue budget for 2025-26. That document recorded a described "modest" underspend of £732,000, which the report attributed largely to additional income received in the final quarter.
At the same time, the council drew £2.68 million from its reserves during the year. After those movements, the overall reserve balance stood at £58.65 million at the year end, according to the report.
| Item | Figure |
|---|---|
| Capital programme (reported worth) | More than £88m |
| Actual capital spend 2025-26 | £91.9m |
| Revenue underspend | £732,000 |
| Reserves drawn | £2.68m |
| Reserve balance at year end | £58.65m |
| Tata Transition Fund paid out | £1.954m |
Council leaders stressed that the movement of funds between 2025-26 and 2026-27 was an issue of timing rather than overspend on projects. That distinction will be important as the authority finalises plans and timetables for the coming financial year, ensuring services and capital delivery remain aligned.
For Neath residents, the accelerated progress brings visible benefits: the new Welsh-medium primary school and completed work at Gnoll Country Park are tangible improvements to local education and leisure provision. Early completion of highways drainage also reduces short-term disruption and improves resilience on a key route into Port Talbot.
Nevertheless, councillors will want to keep a close watch on how forward-spent budgets are balanced against the 2026-27 programme, and on any knock-on effects for scheduling and procurement. The cabinet noted the capital report and received the revenue update at the same meeting, underscoring the council’s dual focus on delivering projects while safeguarding its medium-term financial position.
As the new financial year unfolds, local communities will be watching for clear timelines for remaining schemes and confirmation that the council can maintain momentum without compromising future-year plans.
